-Ripple- Ultralight dinghy from scratch build 11 entries, 42 photos Back to the log

The book is laid out for the paper chosen above, and the print dialog will follow it, so pick the paper here rather than there. Turn background graphics on so the cover photograph prints, and leave margins at their default. The page numbers and the chapter running heads are drawn by the browser into the page margins, so they exist only on paper: check the print preview rather than this screen for them, and turn Headers and footers off there so Chrome's own furniture does not crowd them out. Chrome and Edge print them, Safari and Firefox print the same book without them.

new build

-Ripple- Ultralight dinghy from scratch build

Ultralight Dinghy

Mark Elwell · 2025 to 2026

A build log

-Ripple- Ultralight dinghy from scratch build

Ultralight Dinghy

kept by Mark Elwell

2025 to 2026

The boat

Ultralight Dinghy

Designer
John C. Harris
Plans from
Chesapeake Light Craft
Length overall
6′ 0″ (1.83 m)
Beam
3′ 4″ (1.02 m)
Hull
plywood
Construction
stitch and glue
Started
3 October 2025
Built by
Mark Elwell

I have been thinking about a dinghy for my boat. After looking around for a commercial built dinghy under 50 pounds, found that I may have to build it. So I ordered the PDF files from Chesapeake light craft to build the ultralight 6 foot dinghy. I am going to build it from scratch with no kit, maybe save a little bit of money in the process. Hopefully I can keep the weight under 45 pounds.

What it took

By the numbers

212
Hours at the boat
11
Days written up
42
Photographs
595
Words written
$848
Spent in all
Went into the boat $534.09
Tool or consumable $313.97
Total$848.06

The work

Contents

Chapter 01

Plans & Lofting

Reading the drawings, lofting full-size, making patterns and templates.

1 day 24 hours $119 from August 2025

Plans & Lofting 24 h

Transferring plans and making router templates.

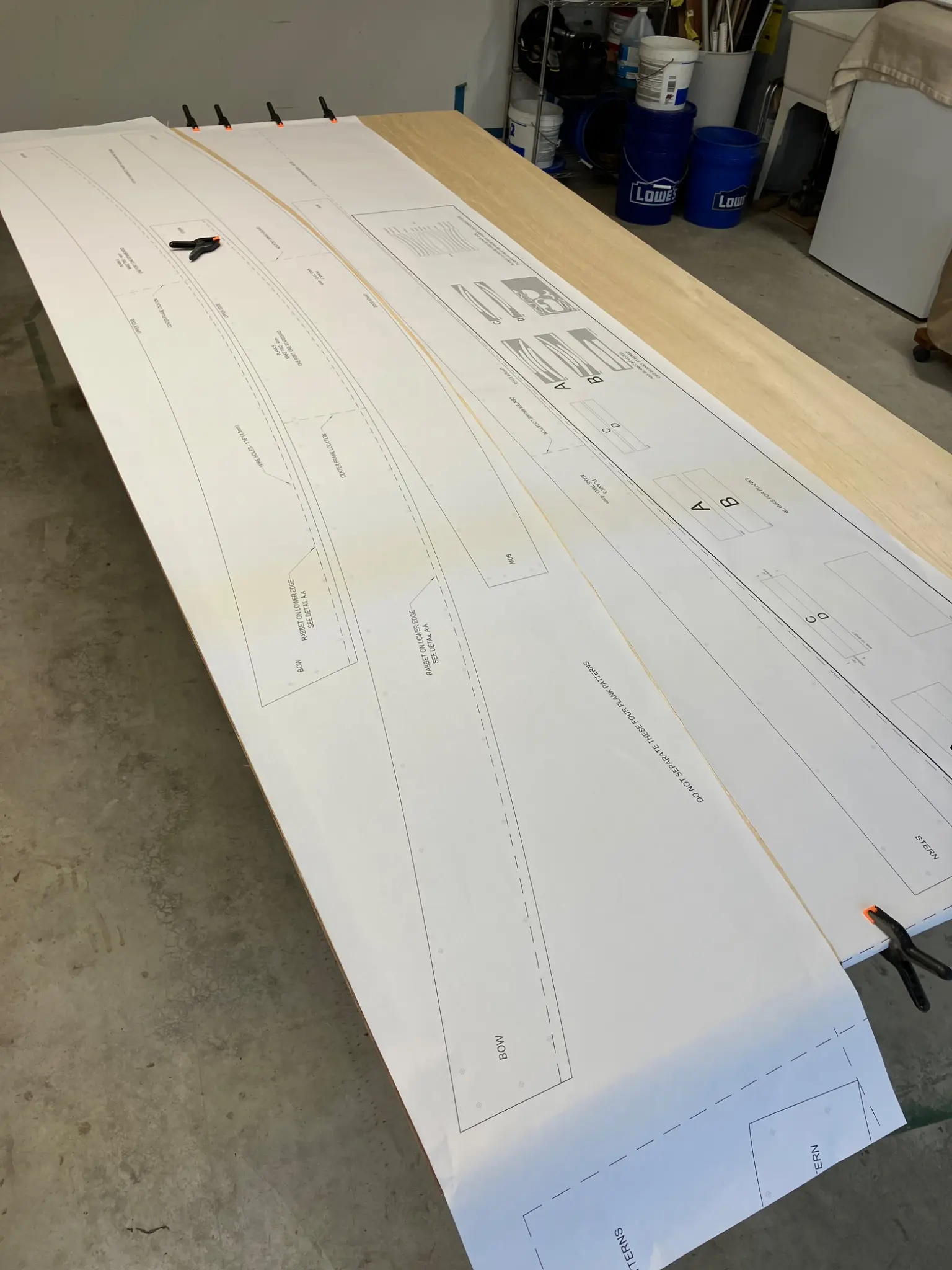

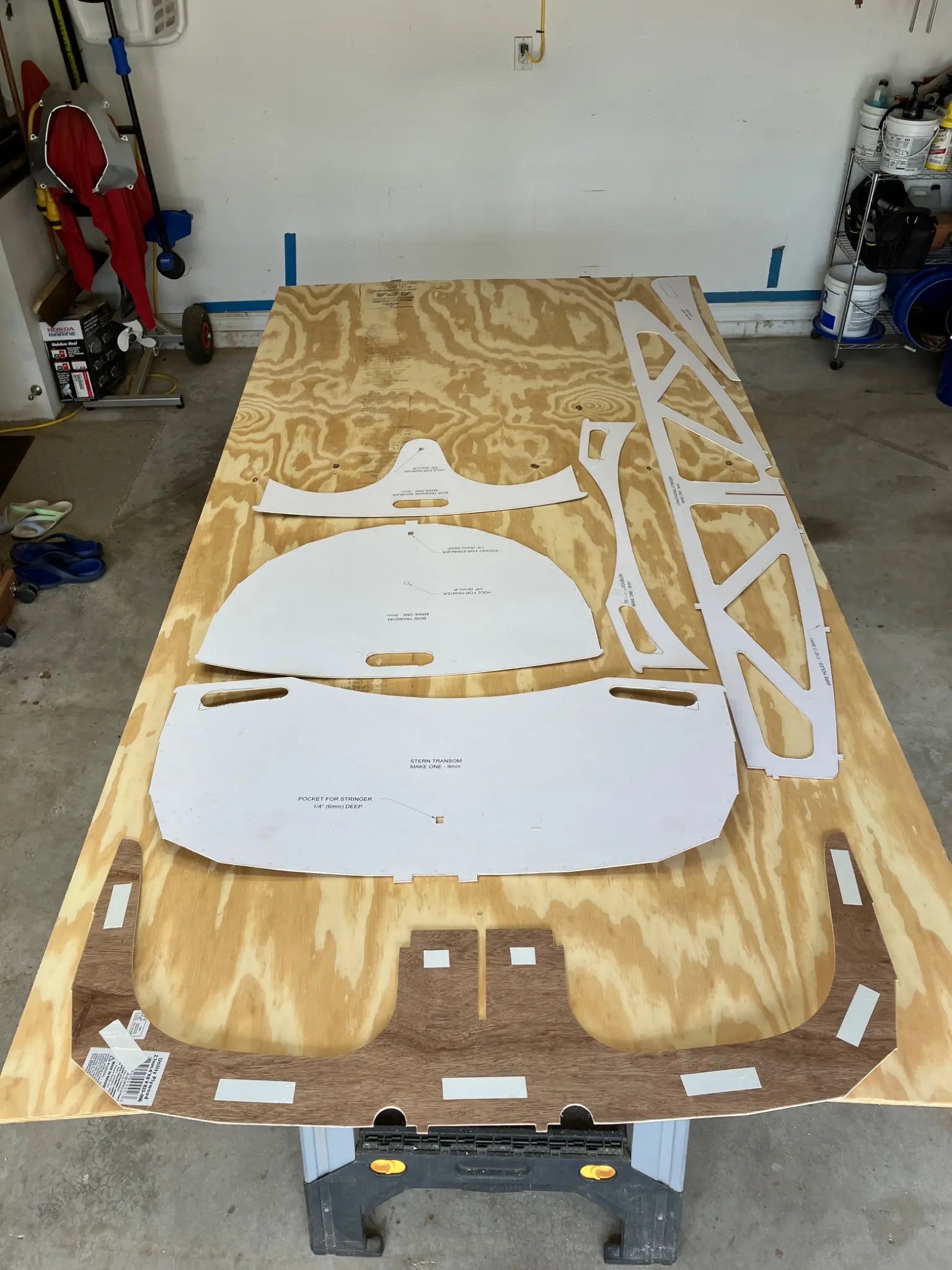

I went to an architect to have the PDF plans printed out. Then I glue them to a thin piece of plywood to make templates for the router to follow on the finish planks later on.

Chapter 02

Stitch & Assembly

Wiring or clamping the hull together and getting it fair and true before glue.

1 day 24 hours from December 2025

Stitch & Assembly 24 h

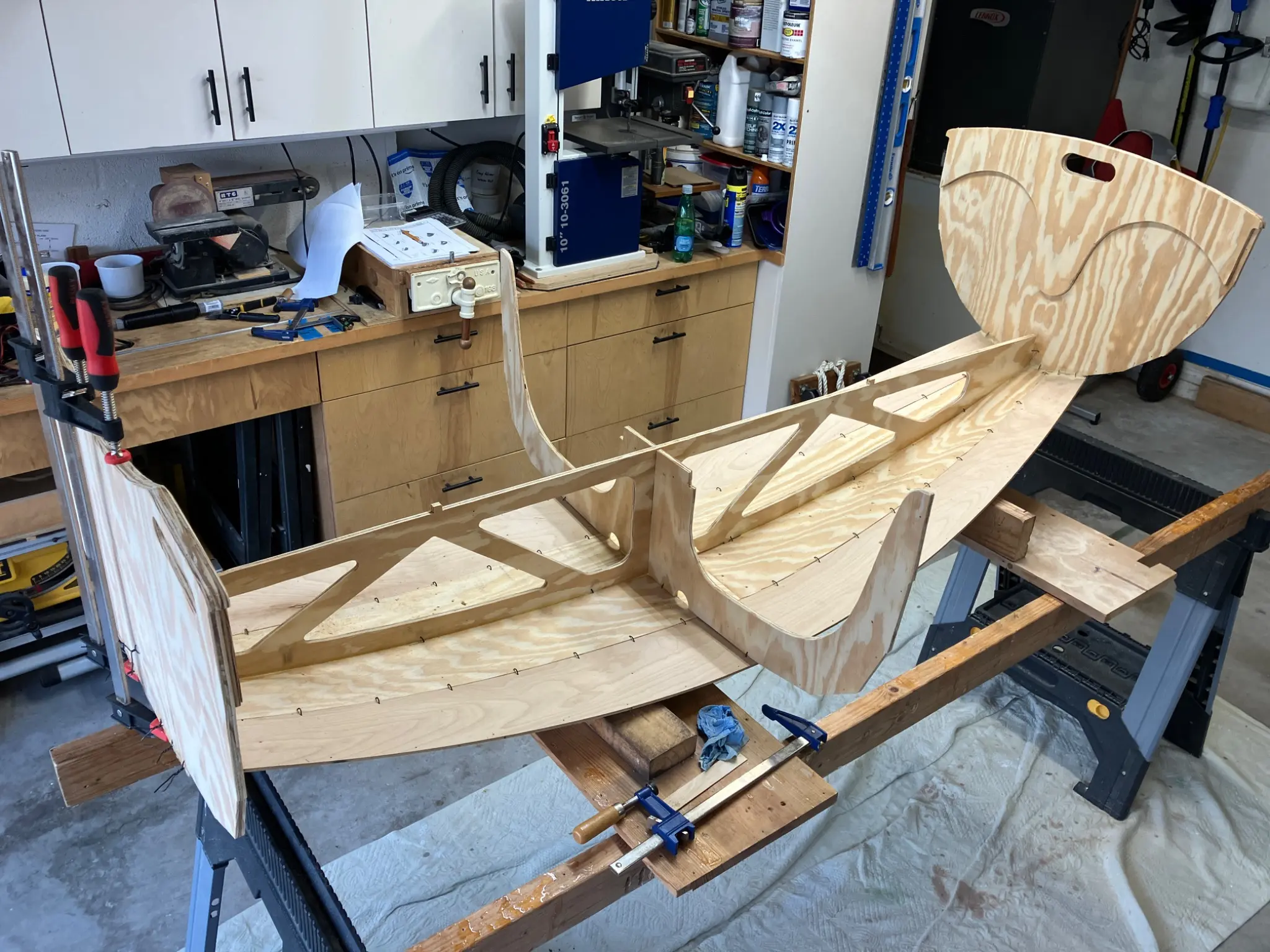

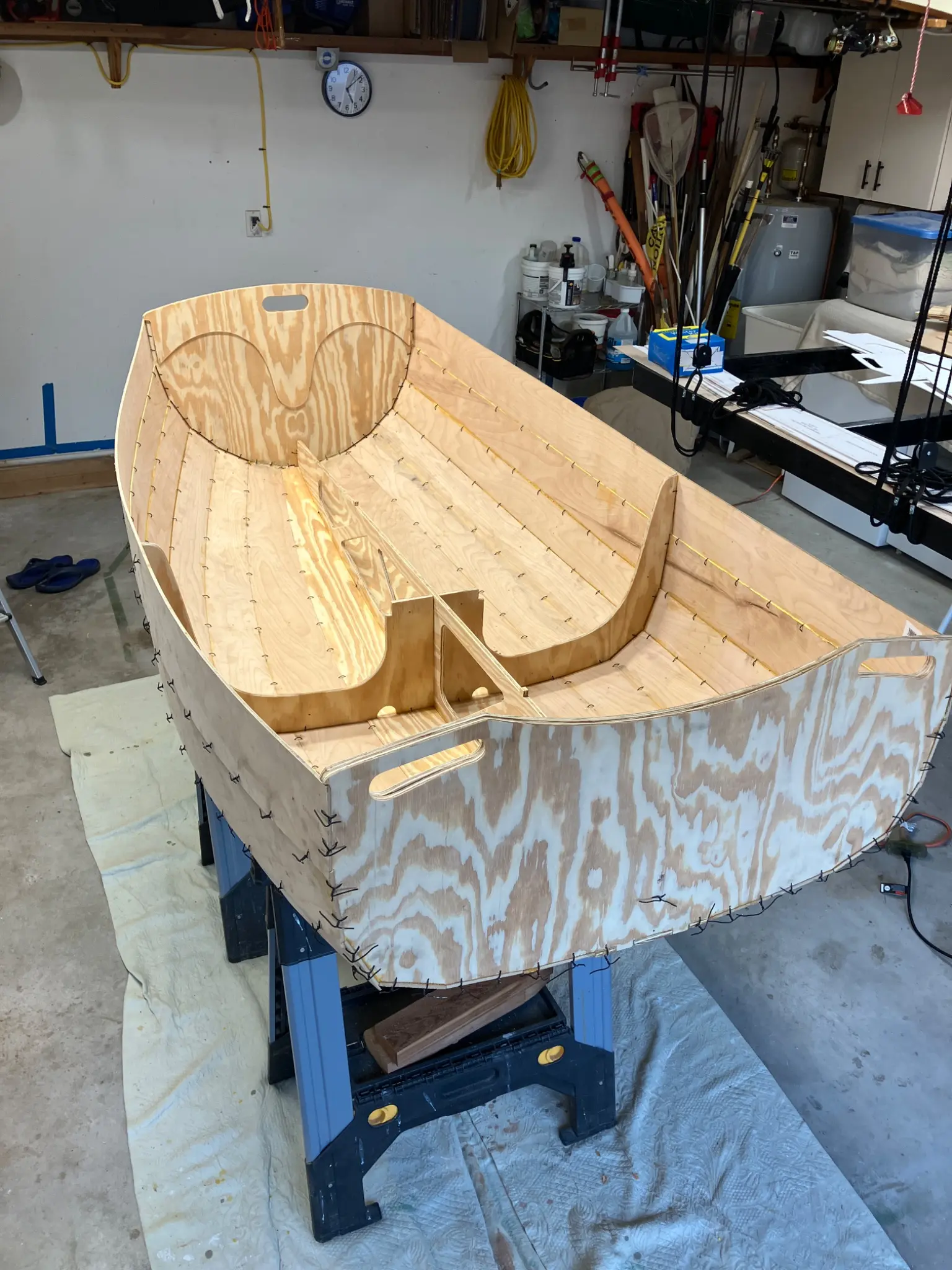

Cutting planks from plywood, assembling, and stitching planks together.

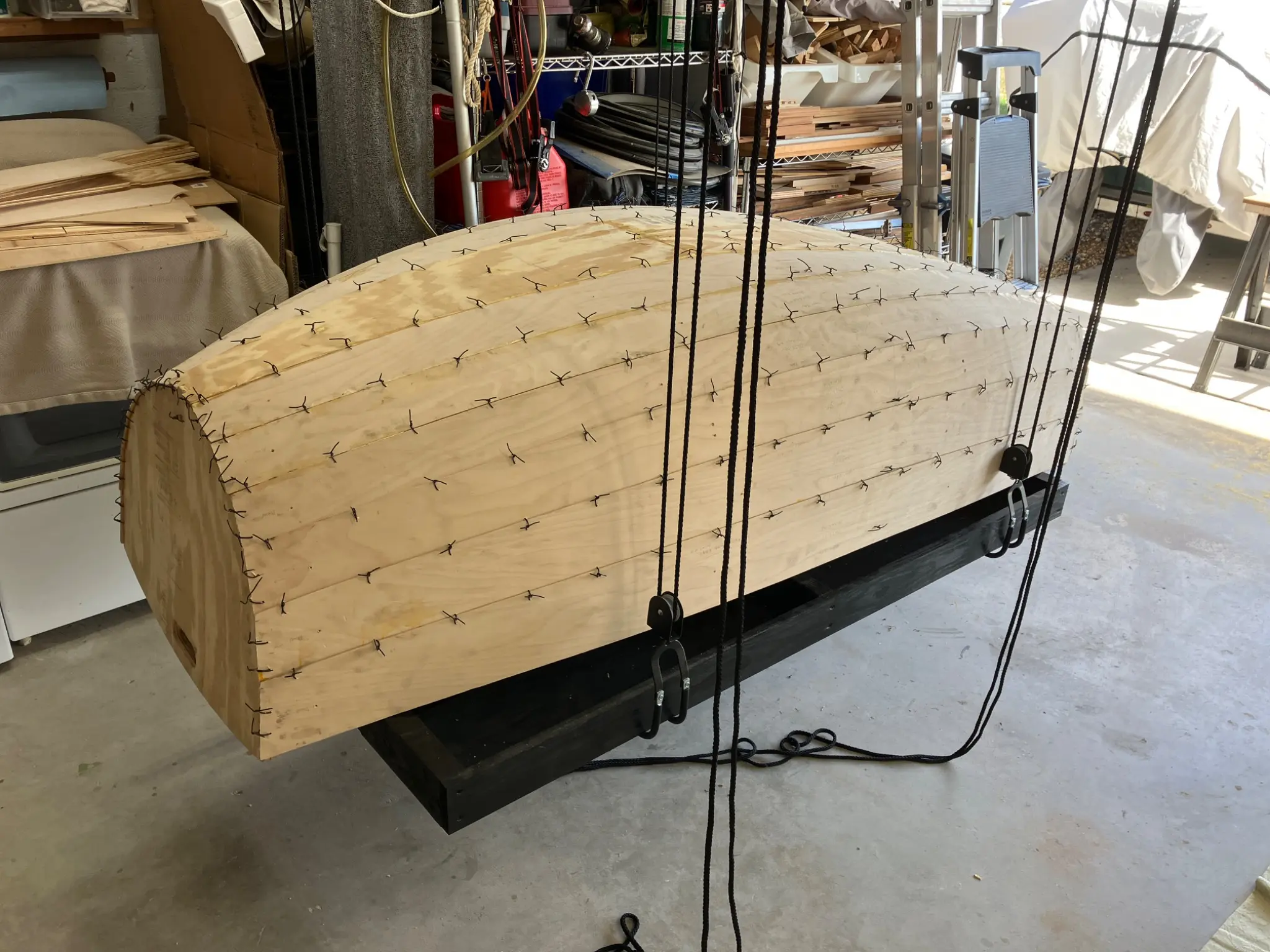

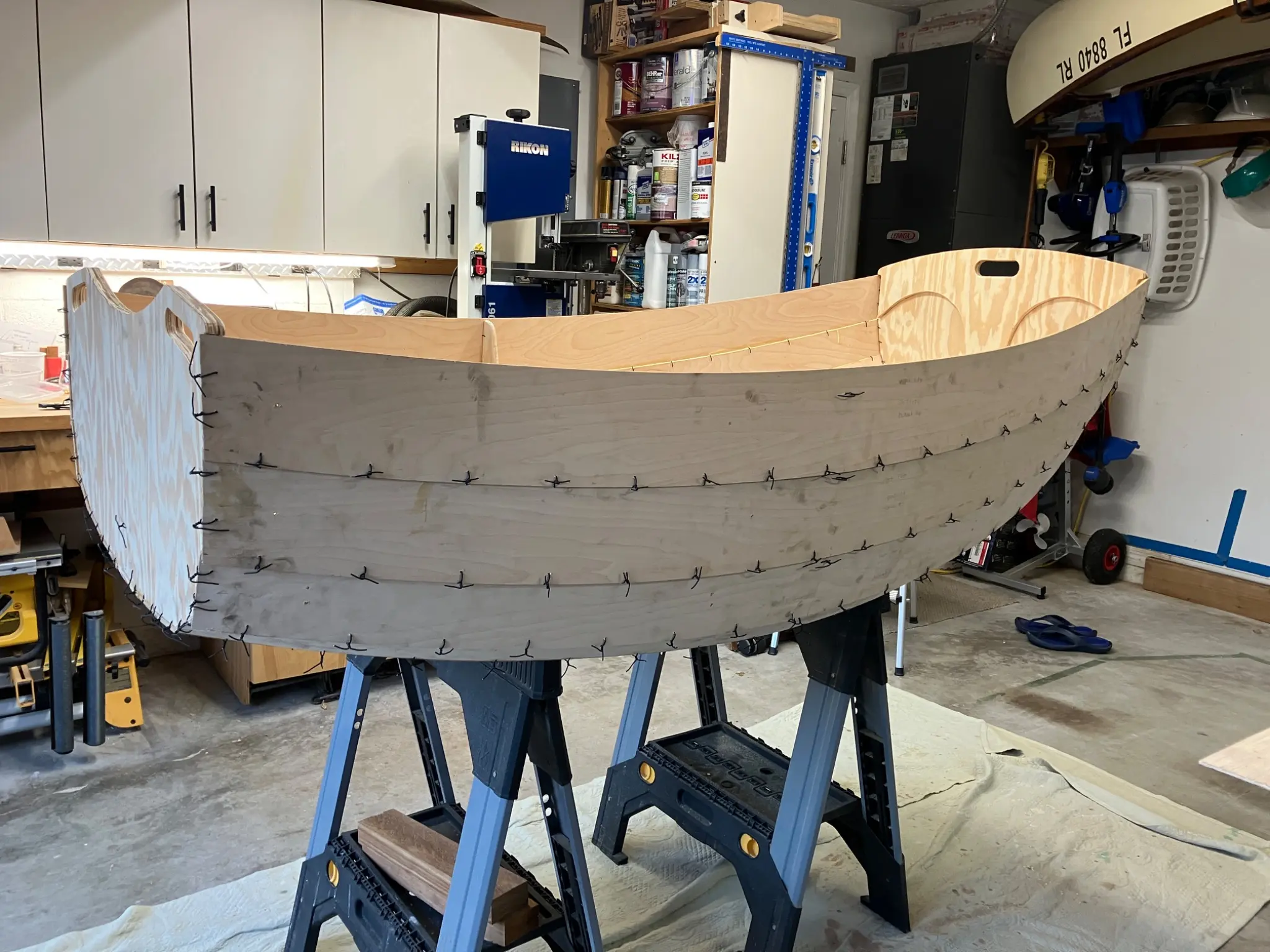

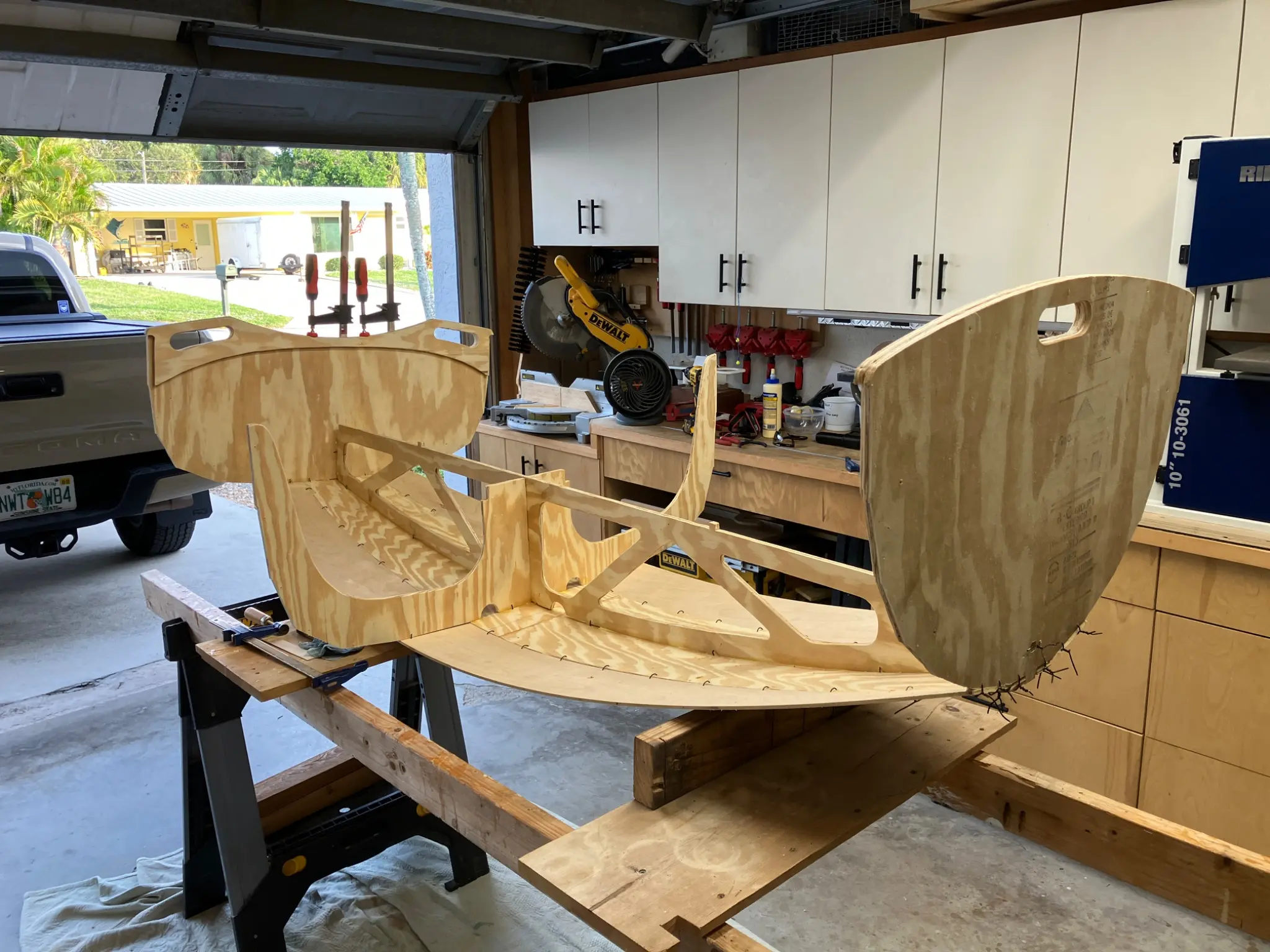

After cutting out all the parts with the router. I carefully laid out all the planks in the correct order right, left, ins, and outs. I didn't use copper wire, I used less the expensive soft steel baling wire for the plywood stitches that I got from Home Depot. I used Tight Bond 2 to glue all the planks together instead of superglue. That's what I had in the shop, so I just used what was on hand. My wife helped me hold each plank and with the stitching. Then we celebrated the last plank with a shot of whiskey!

Chapter 03

Fillets & Taping

Epoxy fillets, taped seams, structural joints.

1 day 24 hours from March 2026

Fillets & Taping 24 h

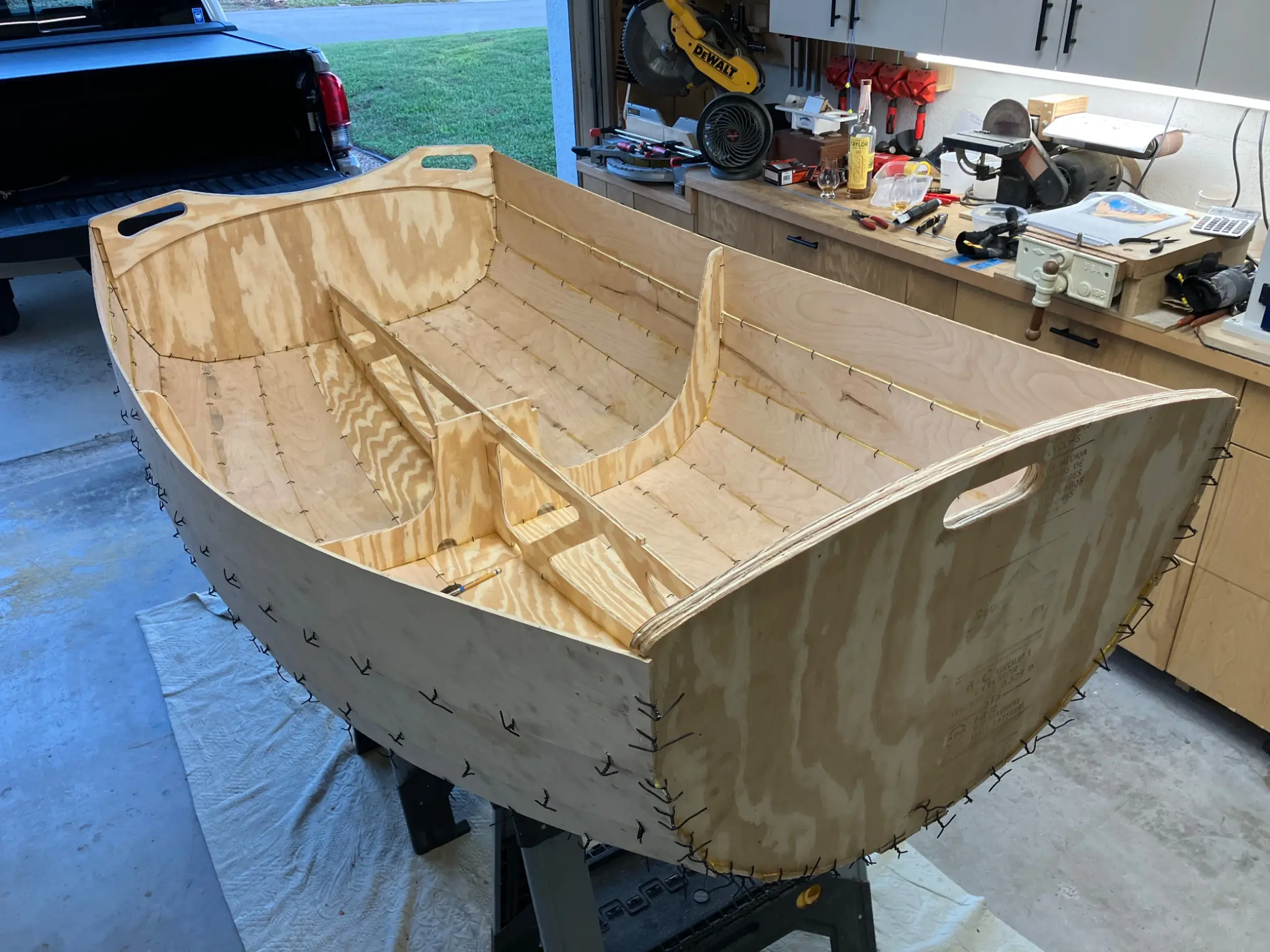

Fillets and glassing the inside of the hull.

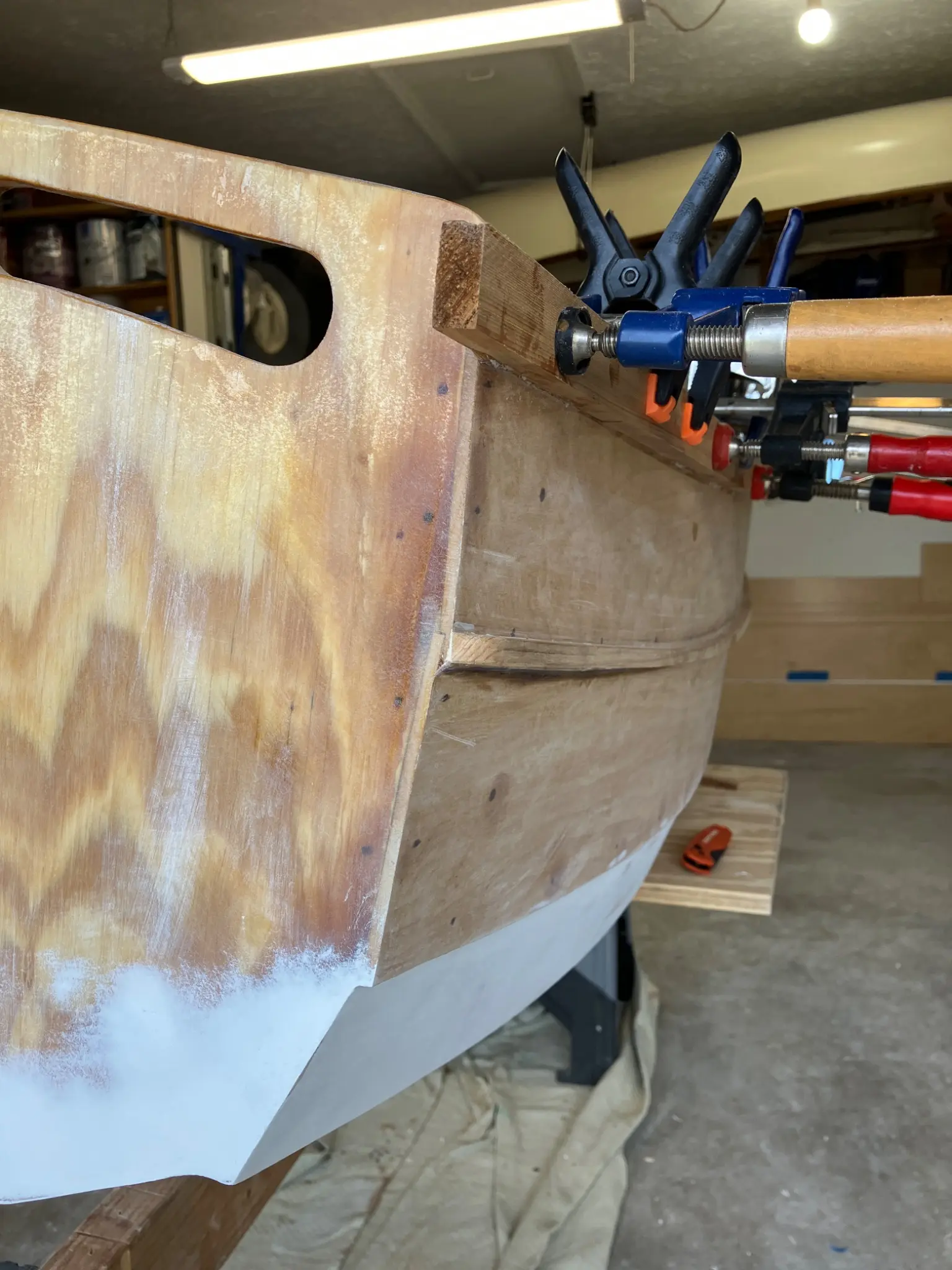

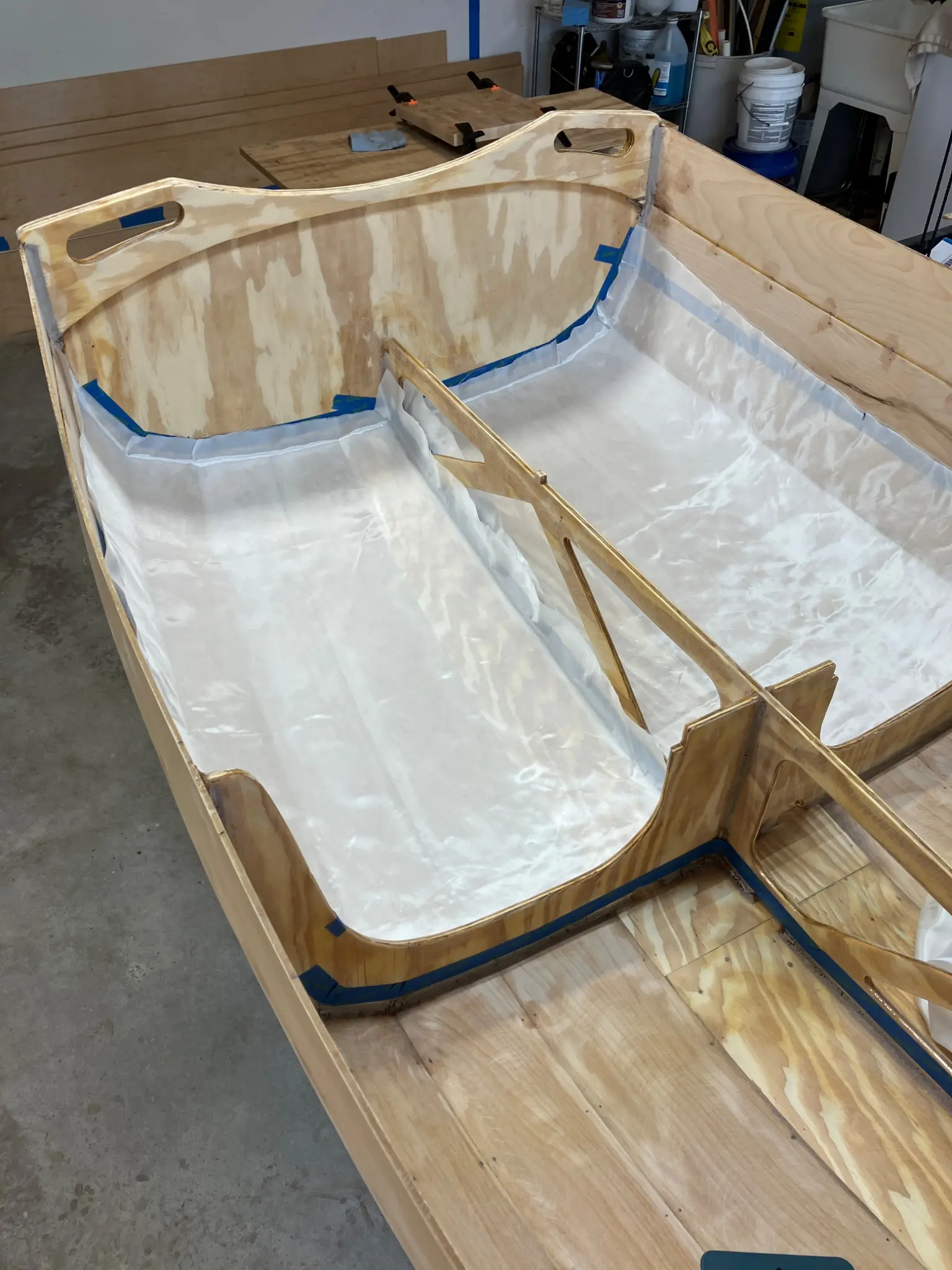

After removing all the stitches, the boat was strictly held together by wood glue only. I fill it at the inside of the planks with wood flower and resin. After grinding down the rough fillets on the inside. I laid out the 4 ounce fiberglass cloth on the inside of the boat. Taped off the areas that I didn't want to have cloth so I could cut it easier later on after the resin set up.

Chapter 04

Glassing & Epoxy

Sheathing in cloth, wetting out, fill coats.

2 days 42 hours from March 2026

Glassing & Epoxy 24 h

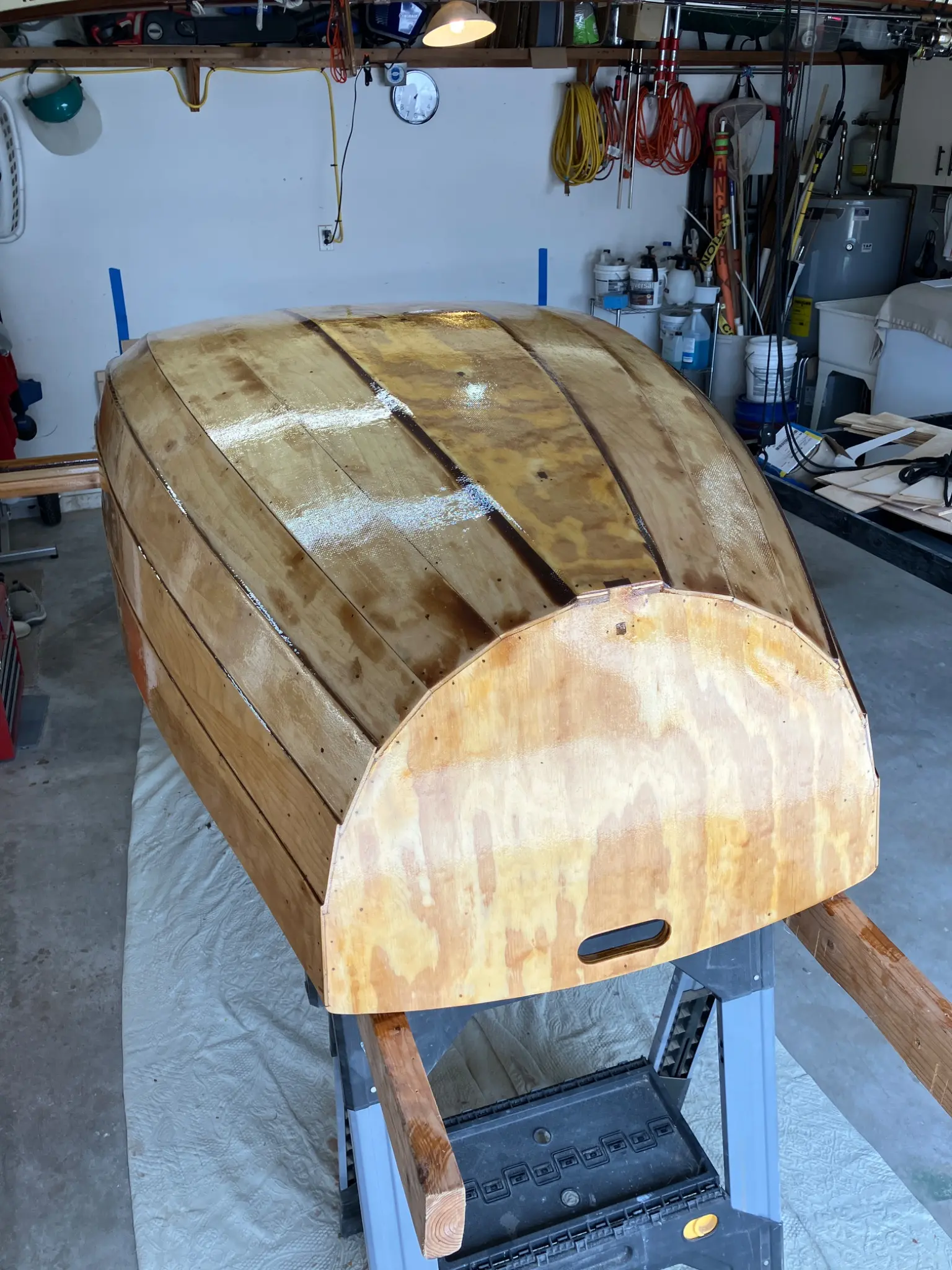

Flipped the boat over, filleted all the board joints. Installed the 6 ounce cloth to the bottom and the keel. Built out the seat, trimmed, continued filling, sanding, faring, and all the stuff you would do to build up the finish of the hull before painting.

Glassing & Epoxy 18 h

Keel installation

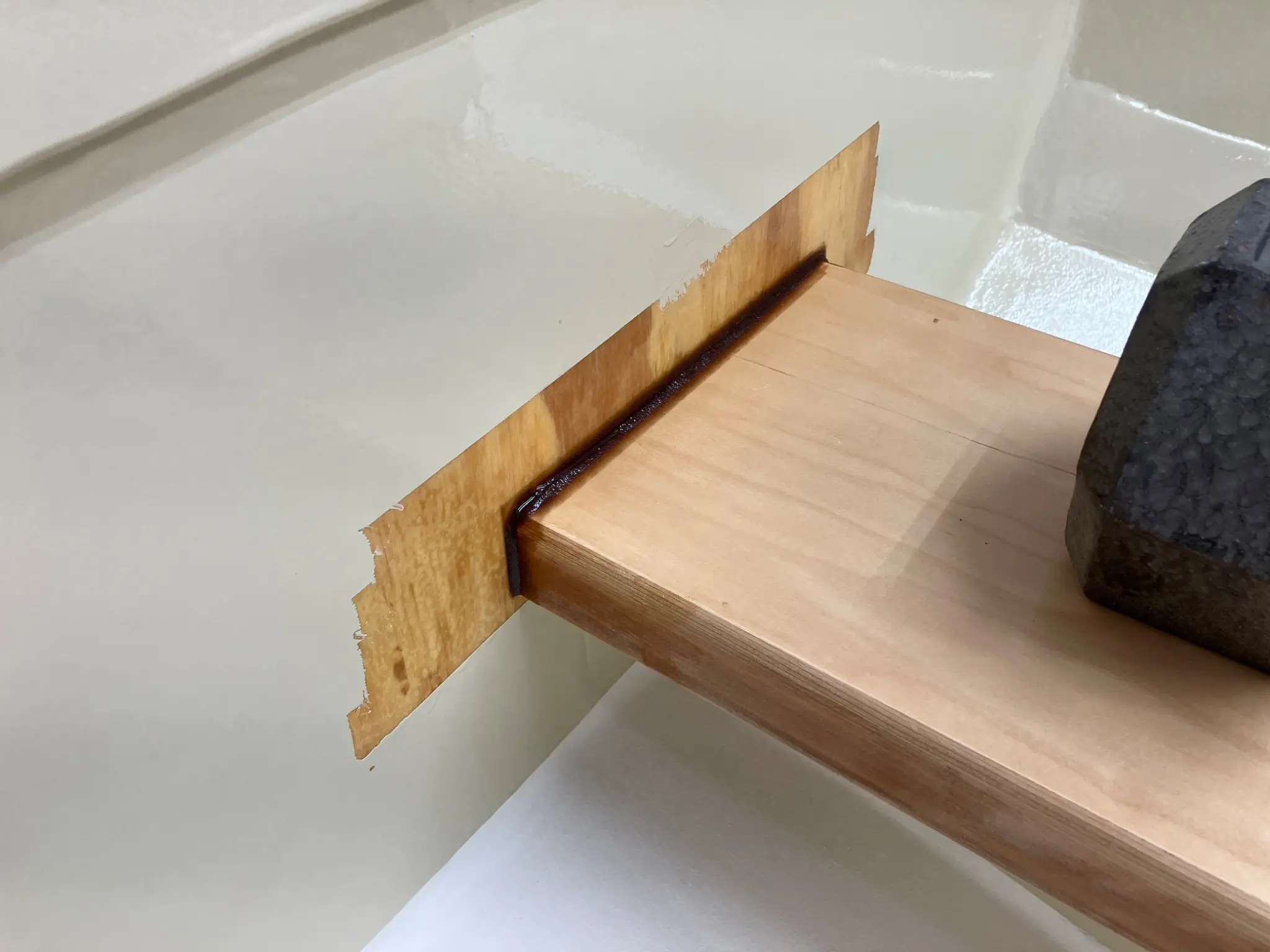

This picture displays the keel after it was installed and filleted. I didn't cut a handle in my keel. Wanted to have the best tracking when I towed behind the boat.

Chapter 05

Hull Exterior

Turning over, keel and skeg, rubrails, exterior structure.

3 days 48 hours from April 2026

Hull Exterior 16 h

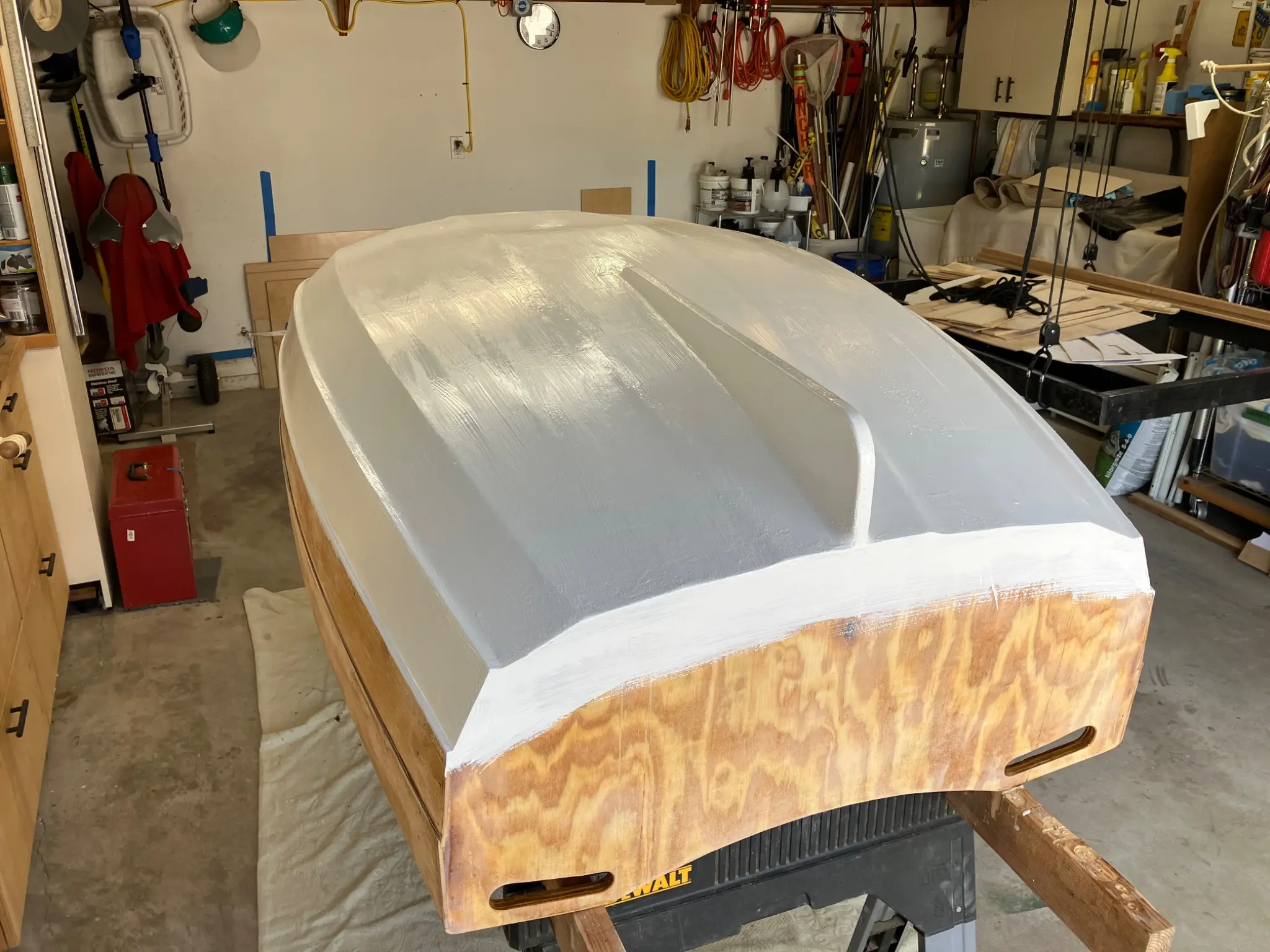

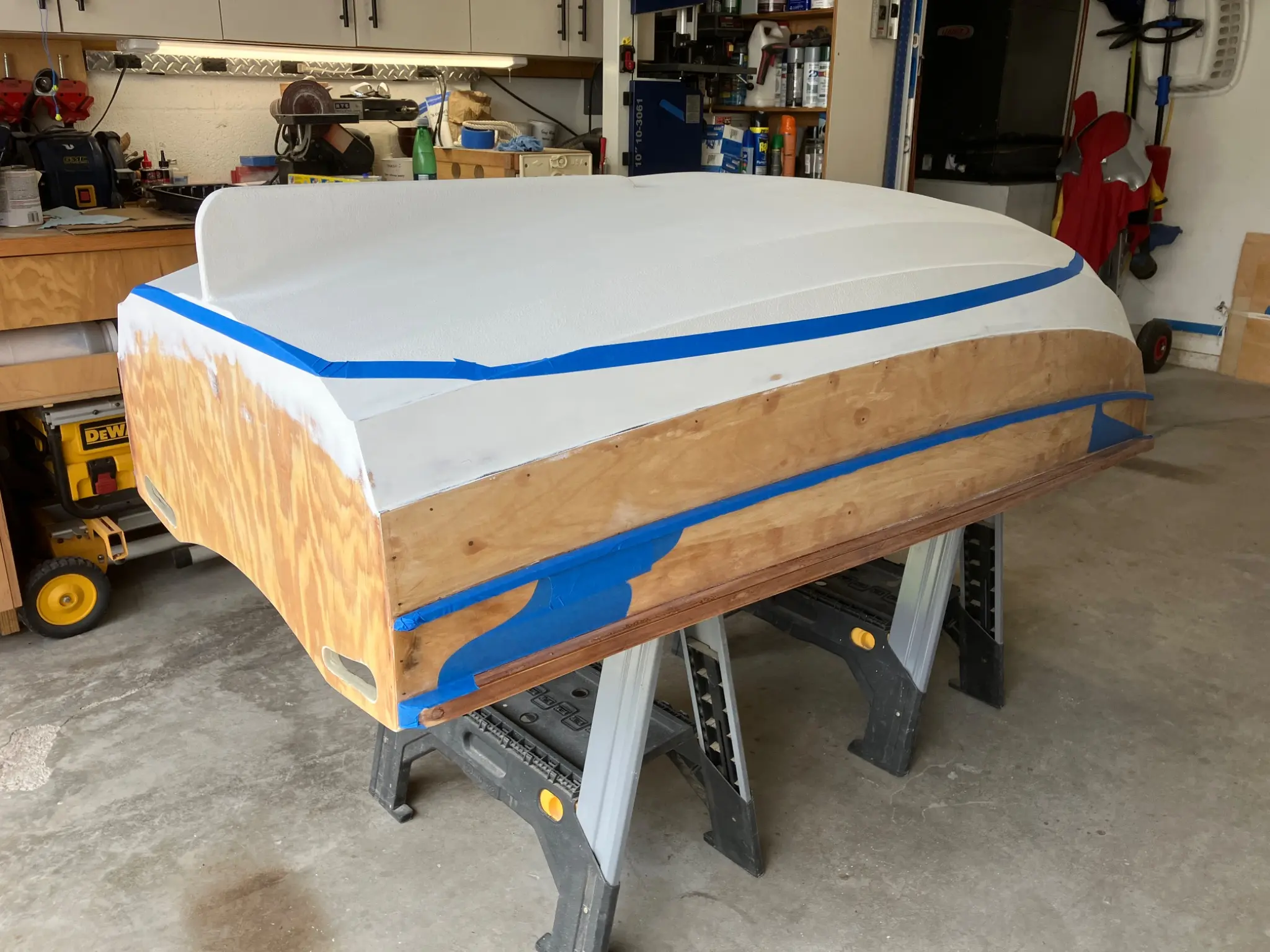

Adding a durable gel coat bottom.

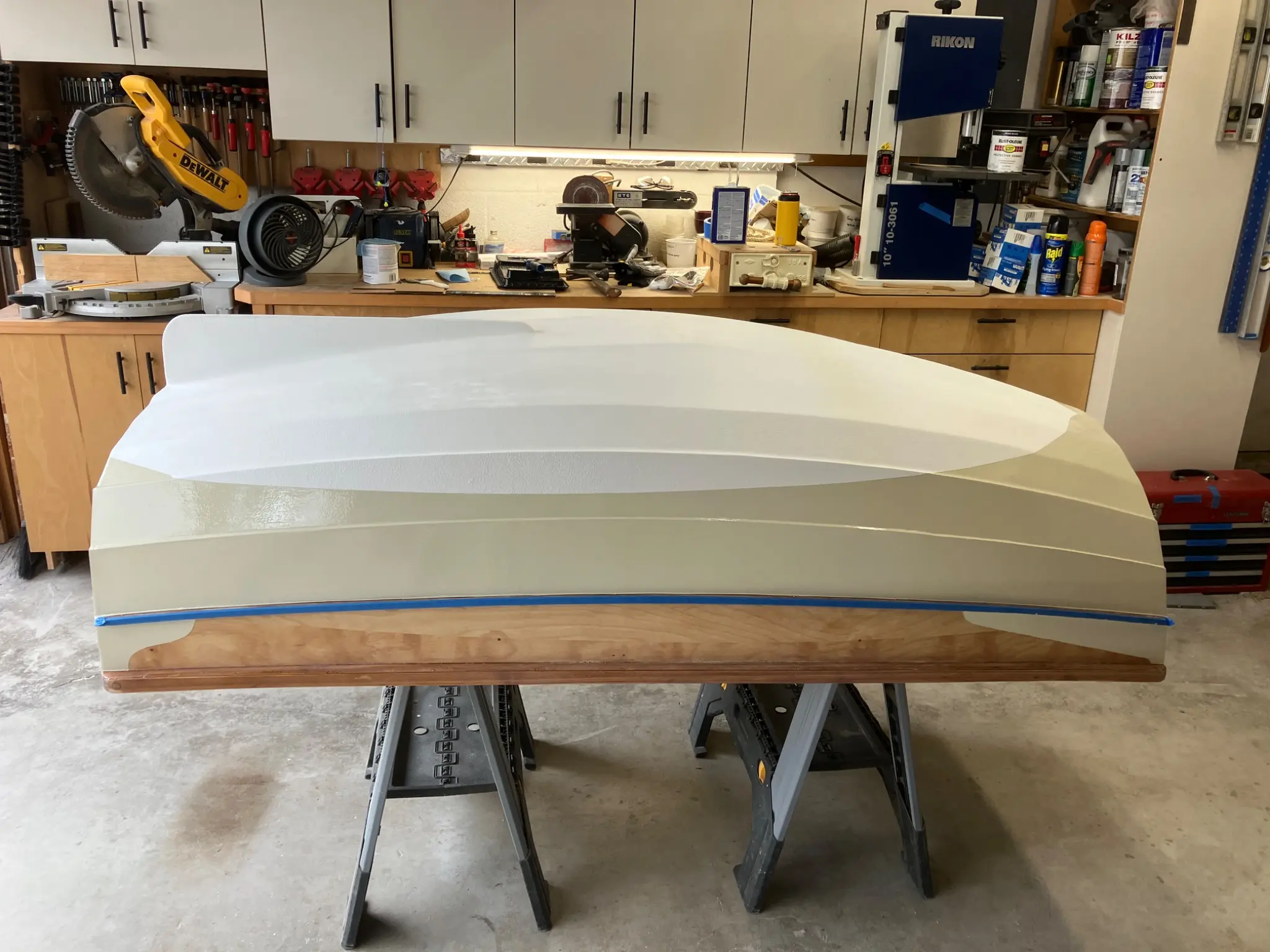

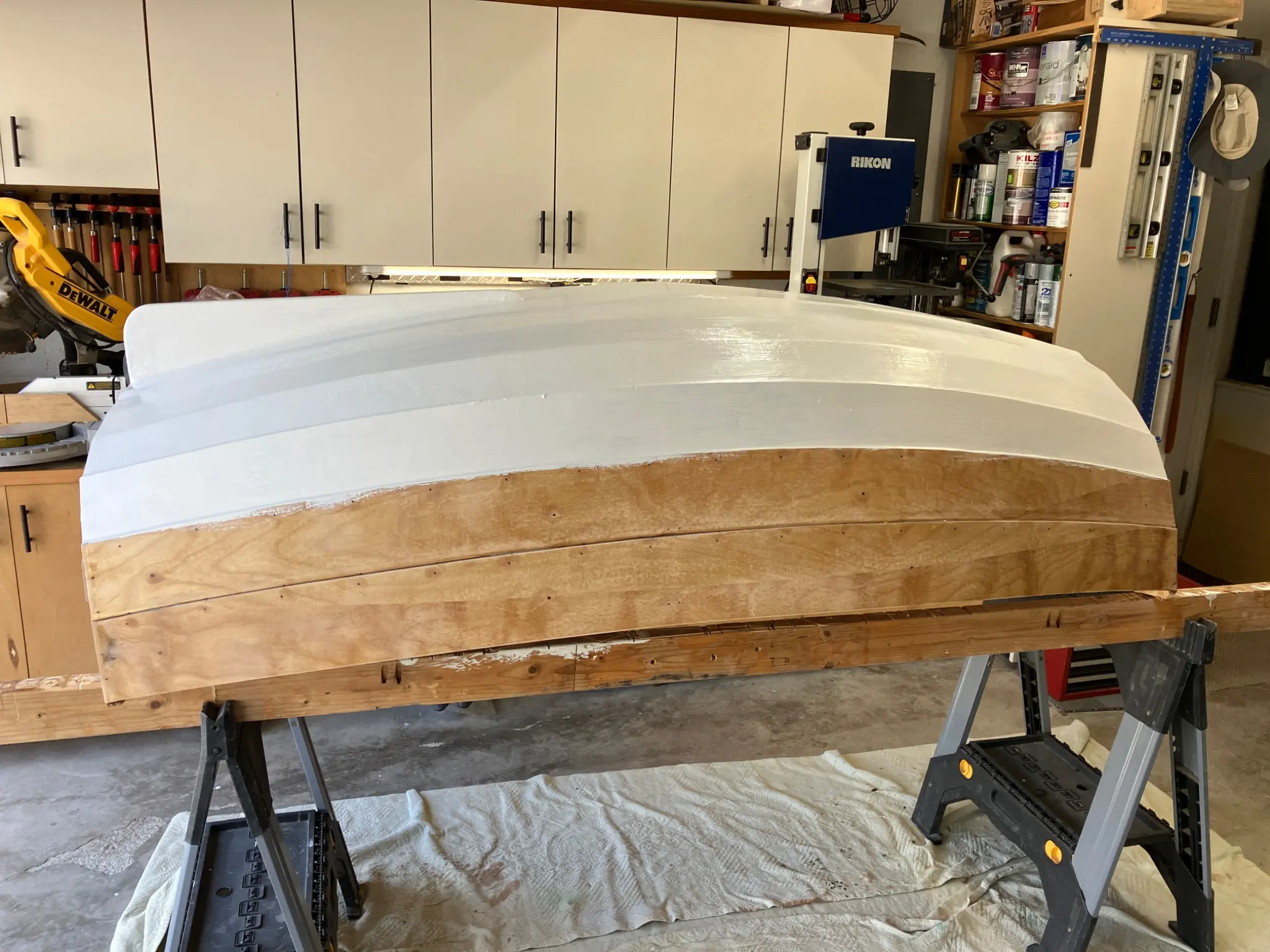

When I built this dinghy, it was meant to be used and abused. So I didn't want to have a fancy nice clean painted bottom that was gonna be high maintenance and scratch easy. So I built up the bottom with gel coat nothing fancy, just rolled it on with a high build nap roller. I was going to polish it up and make it shiny but then I thought it's gonna get scratched up anyway, so I left it the way it was. It has six coats of gel coat on the bottom. By doing this, it adds substantially to the weight of the finished boat.

Hull Exterior 24 h

Rubber rail installation.

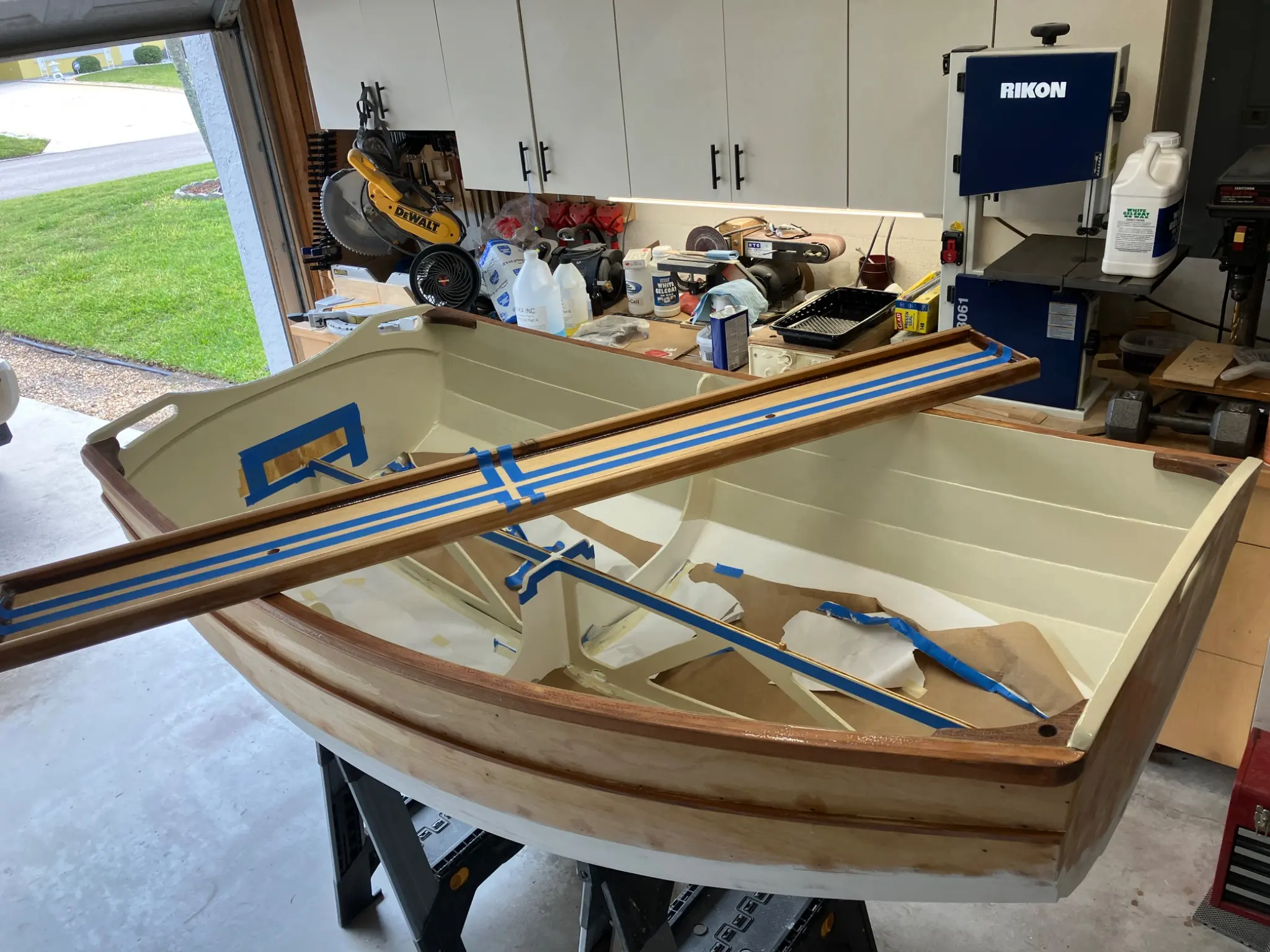

These pictures show how many clamps it takes just to put one side of the rub rails on. The boat is so small and curvy that I had to strip the rails into two pieces to make the compound bends in such a short distance of 6 ft. I used western red cedar for the rails this saves on weight and rot resistance.

Chapter 06

Interior & Cockpit

Bulkheads, seats, buoyancy, sole, storage.

3 days 50 hours from May 2026

Interior & Cockpit 24 h

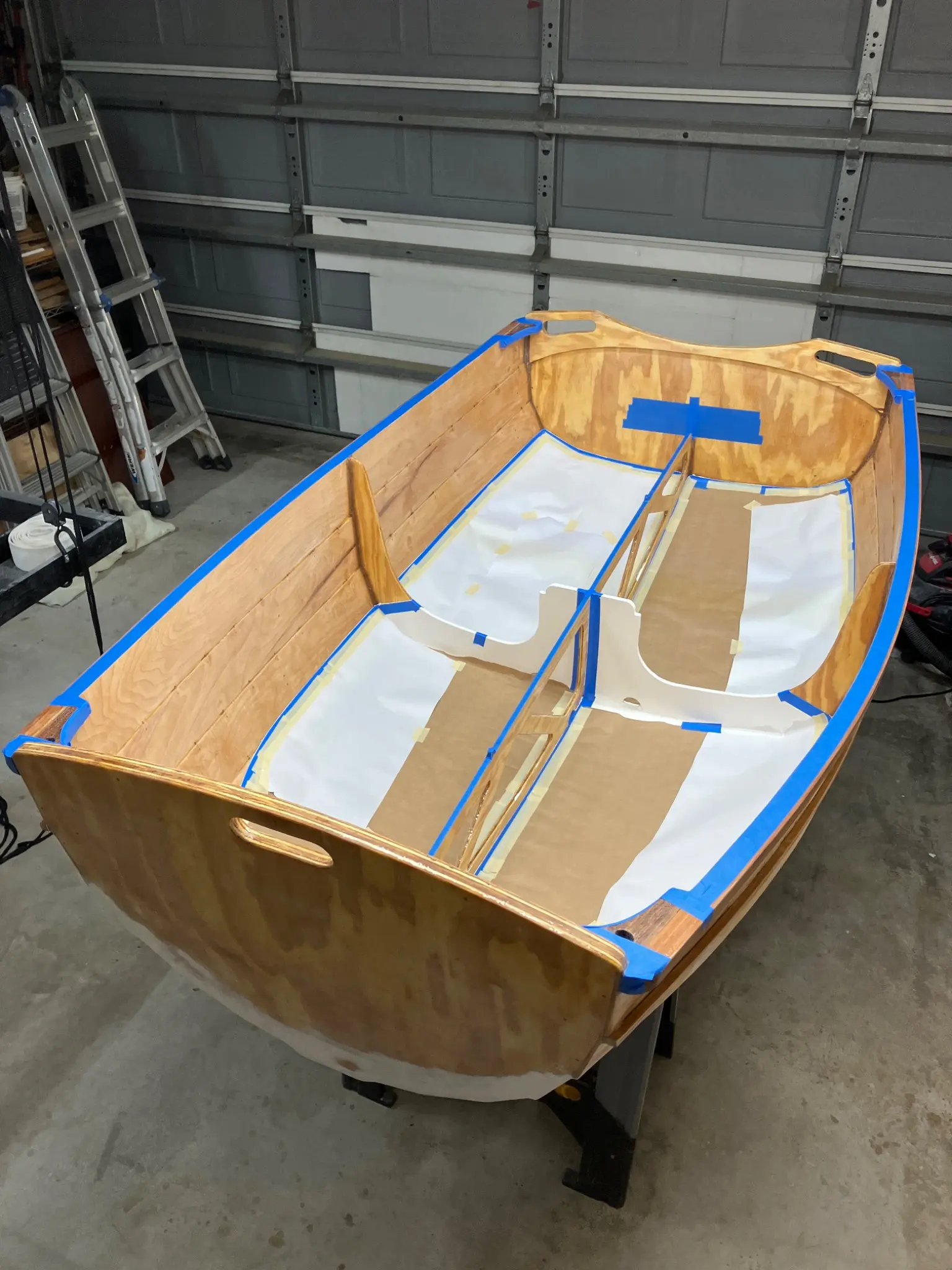

Painting inside

These pictures show the taping that went in for the interior paint job. A gel coat of the inside deck for more durability and scratch resistance. On the sides, I painted with almond Rust-Oleum "out of the can enamel" from Home Depot. Nothing fancy or expensive, just wanted it to work, and look good.

Interior & Cockpit 18 h

Seat installation.

This is when I installed the bench seat. The bottom has fillets underneath to the strong back. The front and back parts are flooded to the stern bulkhead and bow bulkhead. I was able to get a workout in during this time. Notice the white gel coat in the floor for durability and ease of cleaning.

Interior & Cockpit 8 h

Struck a waterline, more taping for the green accent, stripe under the rub rail.

Hull Exterior 8 h

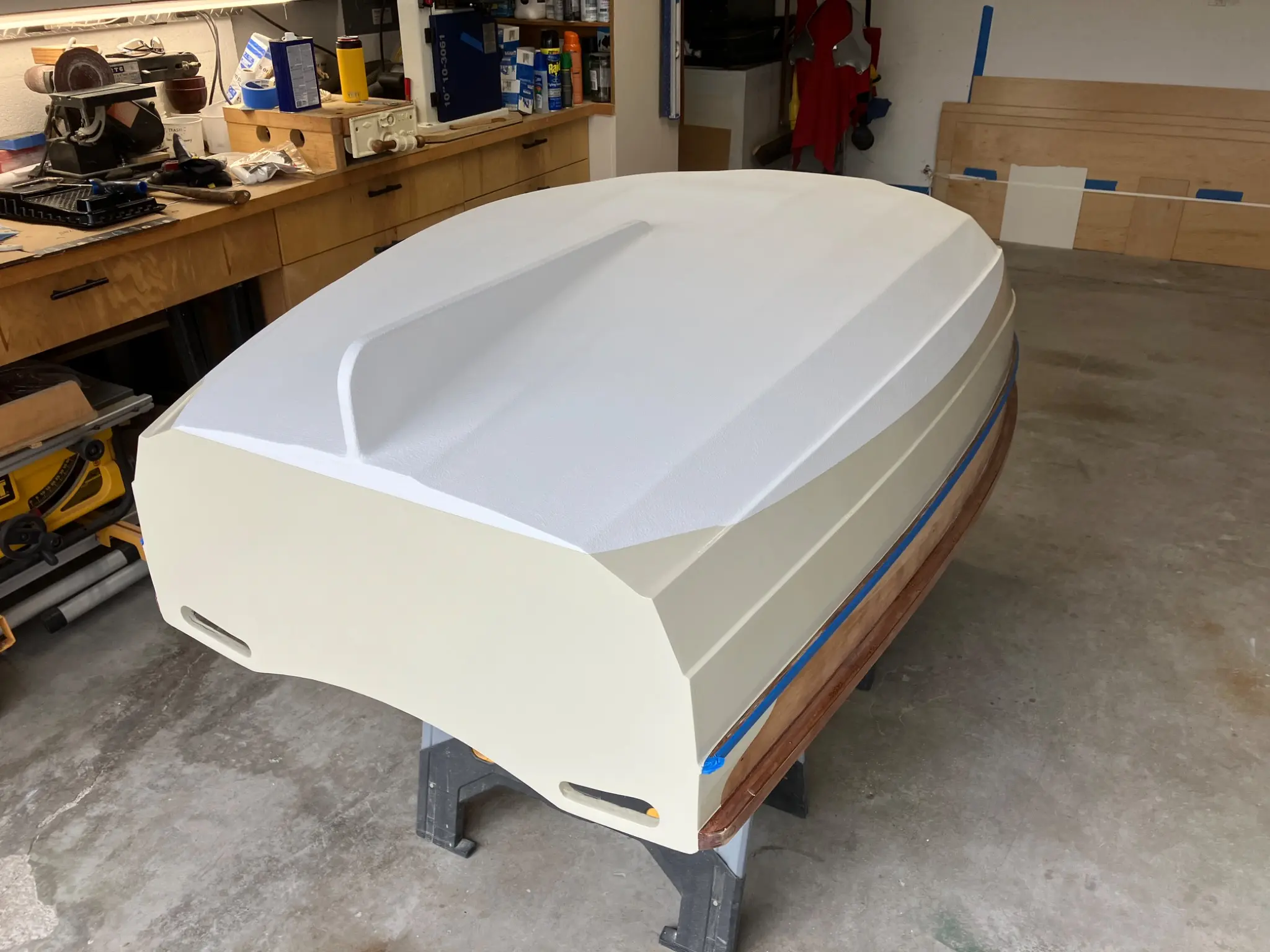

Exterior paint work.

These pictures show the outside paint job almond Rust-Oleum enamel. I rolled and tipped this paint.

The bill

What it cost

Everything else
Tape, paint brushes, rollers, misc. 24 $32.00
Chesapeake light craft digital plans One PDF file download Chesapeake light craft $89.00
Router bits 3 Amazon $58.56
Harbor freight, Palm router 1 router Harbor freight $90.94
3mm door skin plywood 2 sheets Home Depot $30.00
1/4 " sheets of birch plywood 2 sheets Home Depot $160.03
16 gauge wire steel 1 roll Home Depot $13.47
4 ounce fiberglass cloth 3 yards Amazon $21.39
Slow cure high UV resistant epoxy resin 1.5 gallon kit Fiberglass supply depot, Fort Pierce, Fl. $217.54
2" x 8" x 8' Western Cedar Plank 1 (picked up in damaged bin) half price Lowes $21.39
6 ounce fiberglass cloth 3 yards Family donation to project (free) $0.01
Non-waxed white gel coat 1 gallon Fiberglass supply depot $76.49
Rust-Oleum gloss almond enamel paint 1 quart Home Depot $18.62
Rust-Oleum gloss hunter green. 1 Quart Home Depot $18.62
Total spent $848.06
